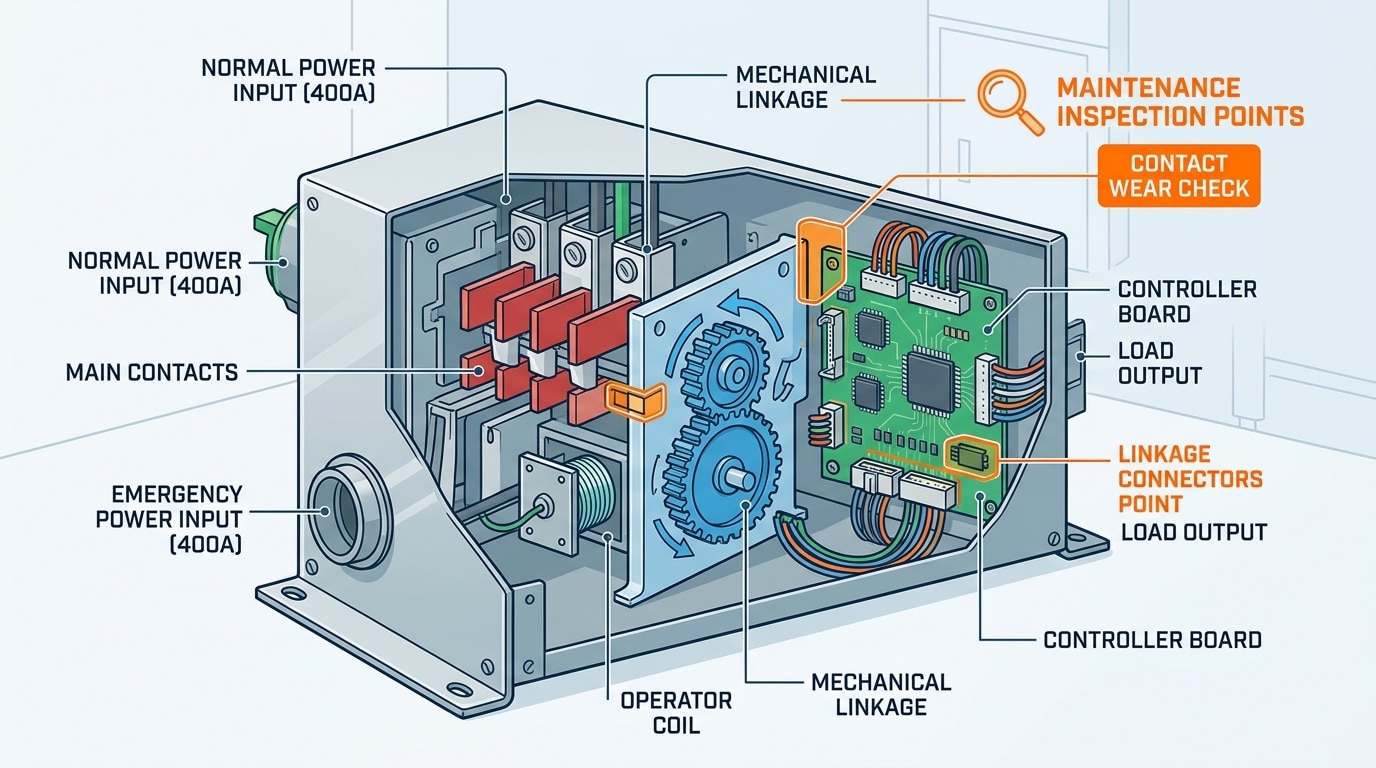

Identity
Nameplate, model, serial, rating, poles, voltage/frequency, controller and asset ID.
A model-aware, recordable program for qualified electrical maintenance teams—covering identity, de-energized inspection, source logic, approved functional testing, deficiencies and the final as-left state.
“With specs” means traceable specification fields—not universal numbers. Enter torque, test stimulus, thresholds, timing and acceptance criteria only from the exact ATS documentation and approved site plan.
Start by identifying the exact automatic transfer switch, its controller, transition type, sources and approved documents. Separate work that requires an established de-energized condition from a planned functional transfer test. For every torque or electrical test point, record the authoritative source, required method, tool or instrument, acceptance criterion and result.
Do not copy a value from another frame, another terminal, an internet chart or a previous project. If the exact criterion is missing, stop that task and record Deferred. The checklist can still document safe progress without pretending an unverified item passed.
What exact asset and revision were inspected? What approved evidence defined pass or fail? What source, controller, generator and bypass/isolation state was left for operations?
Nameplate, model, serial, rating, poles, voltage/frequency, controller and asset ID.
Current applicable OEM documents, one-line, wiring, settings, site procedure and verifier.
Exact point, method, tool/instrument, calibration, criterion, reading, photographs and timestamps.
Defects, owner, risk, due date, retest, as-left state, independent check and acceptance.

Utility, generator, control power, remote start circuits, stored-energy mechanisms, batteries and bypass/isolation paths can cross the work boundary. Controller selectors, test switches, interlocks and displayed status are not substitutes for energy-isolating devices and verified absence of voltage.
For U.S. general-industry work, the facility should evaluate electrical exposure under OSHA Subpart S, including 29 CFR 1910.333. The broader hazardous-energy program in 29 CFR 1910.147 may also apply to unexpected start-up, stored energy and related scope, but it is not the sole electrical-work reference.
A valid number belongs to an exact point, construction, conductor or hardware condition, document revision, test method and acceptance rule. A correct value in the wrong context is still wrong.
Source/load/neutral/ground lug, bus joint, terminal block and mechanism fastener can have different instructions.
Record location, hardware, conductor, value, units, preparation, document page and calibrated tool.A maintenance torque check is not automatically the same as the installation torque procedure.
Do not re-torque unless the exact OEM maintenance procedure requires it.Test voltage, isolation, disconnected components, instrument rating and pass criterion depend on the installed design.
Do not apply an unsanctioned dielectric or insulation-resistance test.Source thresholds, delays, transition behavior and maintenance frequency vary by controller, system duty and governing program.
Use OEM, site, legal/insurance, risk, environment and duty history—not a generic calendar.Each card has a before-work input and an after-work evidence package. Treat missing inputs as a hold point.
Before: manufacturer, model/MPN, serial, amperes, poles, voltage/frequency, transition type, controller and firmware if shown.
After: nameplate photo/reference, drawing reference and work-order asset ID.Before: OEM O&M/installation/service manual, rating label, one-line, wiring, approved settings and site procedure.
After: title, number, revision/date, page/figure/table and verifier.Before: exact location plus hardware and conductor identity; confirm whether the approved maintenance method calls for torque action.
After: published value/units, preparation, tool ID/calibration, technician and date.Before: approved scenario, source/load state, outage constraints, expected sequence, programmed delays and stop conditions.
After: start/end, sequence, required timing, alarms, load impact and pass/fail.Before: approved method, isolation, stimulus/test voltage if specified, instrument category/rating/calibration and criterion.
After: test points, readings, relevant ambient condition, result and reviewer.Before: required source, controller mode, bypass/isolation position, generator mode, alarms, covers and labels.
After: independent verification, open defects, owner acceptance and next due date.Five groups preserve the work sequence without turning the page into a switching procedure. For each line, attach objective evidence and choose Pass, Fail, N.A. or Deferred.
Resolve scope, authority and baseline discrepancies before maintenance or testing begins.
Capture: manufacturer, model, serial, rating, pole count, voltage/frequency and controller. Resolve every mismatch before work.
Evidence: document number, revision/date and relevant page, table or figure entered in the control sheet.
Evidence: responsible operator, authority to proceed, hold points and abort criteria are named.
Evidence: team briefing and authorization are documented under the site program.
Evidence: baseline log, export or photographs attached; unexplained alarms escalated before testing.
Photographs and exports are useful only when they can be traced to the exact ATS, work order and document revision. Record discrepancies rather than normalizing them in the field.
Another reviewer should be able to identify what was inspected, which requirement applied and why the status was assigned.

Intrusive visual/mechanical work is de-energized under the approved procedure. Controller data is reviewed only in the OEM- and site-permitted condition.
Accept when: safe access, cooling, identification and environmental suitability are not compromised.
Evidence: suspected thermal or arcing conditions are photographed and evaluated before return to service.
Accept when: no binding, damage, obstruction or missing part exists; no manual operation occurs outside the approved condition.
Accept when: condition agrees with drawings and labels and shows no damage or abnormal heating evidence.
Record: point, source document, value/units, preparation and calibrated tool. Never use memory or a generic chart; do not re-torque an in-service connection unless the exact OEM maintenance procedure requires it.
Accept when: configuration matches the approved design. Escalate discrepancies; do not field-correct by guesswork.
Accept when: labeling, condition, separation and retention agree with approved drawings and no part is loose, damaged or heat affected.
Evidence: data is readable and backed up where available; configuration changes remain prohibited unless formally authorized.
Verify what the installed system reports, then compare it with the approved cause-and-effect and settings record.
Accept when: displayed status agrees with the actual source condition and approved settings record.
Accept when: displayed status agrees with the actual source condition and approved settings record.
Accept when: condition, alarms and readings meet the responsible equipment/system manufacturer's criteria.
Evidence: actual I/O agrees with approved wiring and cause-and-effect; no defeated interlock or unexplained state remains.
Evidence: actual settings and their source document are recorded. Any change requires authorization, backup and a re-test plan.

Two products sold as automatic transfer switches can use different mechanisms, transition modes, controller logic, neutral arrangements, bypass/isolation features, sensing architecture and maintenance access. Even a manual from the same brand can be wrong for another frame or revision.
A functional test intentionally changes system state. It needs operational ownership, expected behavior and stop conditions—not an improvised “simulate failure” instruction.
A photograph can illustrate professional field work, but it cannot prove the pictured method, PPE, isolation, equipment rating or sequence is suitable for another ATS. The approved procedure and exact equipment documentation remain controlling.

Observe only the authorized sequence and exact equipment criteria; preserve load safety and a controlled abort path.
Record: source/load starting state, personnel locations, critical-load approval, communications, generator readiness, abort criteria, named test director, ATS position and controller mode.
Evidence: indications, source availability, transfer position, alarms, load behavior and required delay measurement meet the approved equipment-specific criterion.
Evidence: restore delay, final position, generator cooldown/run-on and indications are recorded against approved criteria with no unexplained alarm.
Evidence: OEM procedure, site plan and competent authority permit the test; record state, key/interlock behavior and as-left position. Otherwise choose Deferred.
Accept when: signals reach the intended endpoint and timestamps correlate with the test record.
Evidence: criteria trace to the installed controller/system; no generic pickup, dropout or synchronization value is substituted.
Make every reading traceable, every unresolved condition owned and the final operating state explicit.
Record: approved method, isolation boundary, instrument category/rating/calibration, points, specified stimulus/test voltage, criterion and reading. Do not perform unsanctioned dielectric or insulation tests.
Evidence: location, photographs/data, risk, compensating measure, owner, due date, operational impact and required retest.
Record: source, controller, bypass/isolation, generator, covers/labels, cleared tools, restored energy-control status, notifications, next due date and independent/owner sign-off. Keep Fail and Deferred visible.
A check mark without identity, authority, measurement context or an as-left state cannot support troubleshooting, review or the next maintenance cycle.
Identify the exact asset and preserve labels, wiring condition, contamination, heat evidence and physical anomalies.
Include context and close-up views with date and asset ID.Tie each torque value, setting and method to the applicable model, revision and approved project document.
Record title, document number, revision/date and page/table/figure.Show the exact point, whether action was authorized, published value/units, preparation and calibrated tool.
Record tool ID, calibration due date, technician and date—not only “checked.”Preserve the pre-test and post-test baseline, settings, alarms, events, time/date and communications state.
Use formal change control and re-testing for every approved setting change.Record scenario, method, criterion, tool/instrument, calibration, points, readings/timing and result.
Keep load impact, alarms, aborts and unexpected behavior visible.Connect unresolved risk to an owner, due date, compensating measure, retest and final operational state.
Require independent verification or owner acceptance before close-out.Use one explicit status for every checkpoint. The status describes today's evidence, not optimism about the equipment.
The approved requirement is known, the in-scope work is complete and objective evidence supports acceptance.
An observed condition, result or final state fails the applicable requirement. Record risk, controls, owner and retest.
The feature or task is outside this exact ATS configuration or approved scope. Document the reason—do not leave it blank.
Authority, document, outage, instrument, access or criterion is unavailable. Preserve the open item and next action.
Set the interval from the equipment OEM, the installation's legal/insurance requirements, critical-load risk, operating environment, generator program, duty history, and site maintenance standard. A calendar-only interval is incomplete; abnormal operation, heat evidence, alarms, contamination, or modifications can justify earlier review.
No. Use the torque value specified for the exact ATS terminal, conductor/lug arrangement, and hardware. If the rating label, OEM manual, or approved project documentation does not provide it, obtain an authoritative specification before torqueing that point.
The exact scope is site- and model-specific, but commonly includes documented visual/mechanical inspection, controller/settings verification, approved functional transfer and retransfer observation, alarm/remote-monitoring verification, and any OEM/site-approved electrical condition tests. Each test needs a defined method and acceptance criterion.
Not as a routine maintenance action. Compare the installed settings against the approved settings record, preserve a backup where available, and use formal authorization plus re-testing for any change. Transfer and source-acceptability settings can affect critical loads and generator operation.
It records the final operational state: the source supplying the load, controller mode, generator mode, bypass/isolation state, alarm condition, covers/labels, unresolved defects, and the person who accepted the return to service. It is the handoff point between maintenance and operations.
For ATS project support, share the exact model and nameplate, one-line, controller, source arrangement, transition type, approved settings, work scope, applicable manuals, fault/maintenance history, critical-load constraints and requested evidence package.
