7 Steps to Wire an Automatic Transfer Switch for Generators
There is no universal generator ATS wiring diagram. A defensible installation starts with the exact switch, generator, system class, transition type and approved one-line—then controls every source, verifies ratings and neutral design, uses only model-specific termination data, and finishes with documented commissioning.
Wire the system through seven verification gates

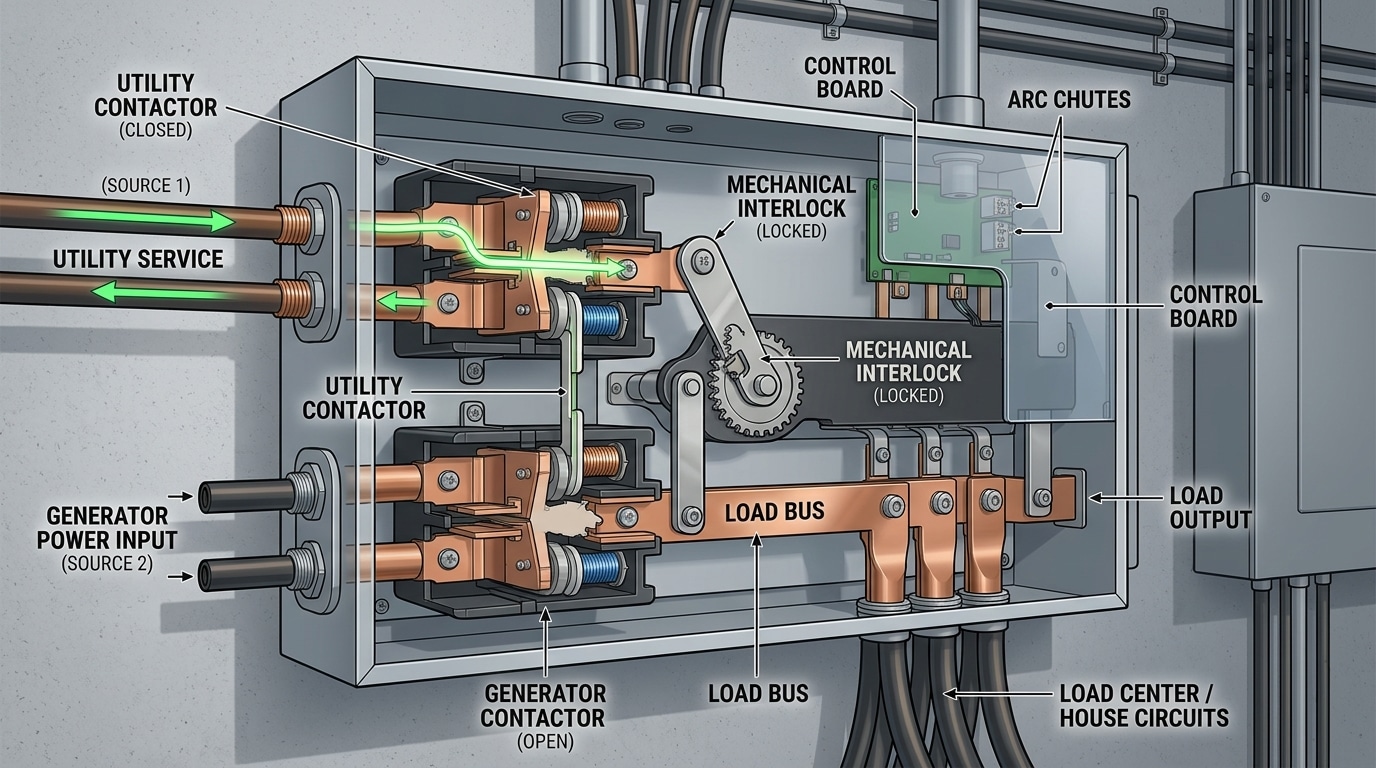

For a generator automatic transfer switch, “wiring” is a controlled project sequence—not an internet terminal recipe. First validate the exact equipment and governing design. Next map the normal/preferred source, alternate/generator source and transferred-load boundary. Then confirm fault duty, protection, conductors and terminals; resolve neutral, bonding and ground-fault protection; document power, sensing, control and communications; complete only the exact model-specific terminations under the approved energy-control procedure; and commission the complete sequence with traceable evidence.
It connects the one-line, equipment markings, conductor schedule, control I/O, neutral decision, settings, inspection evidence, functional test and as-built handover. If one of those records is missing or contradictory, the next step is clarification—not improvisation.
Each gate removes a different system risk
Read the sequence left to right, but treat it as a hold-point process. A later activity cannot repair an unresolved equipment identity, source boundary, rating or neutral decision.
Exact equipment and authority
ATS, generator, controller, options, system class, transition type, approved drawings and adopted rules.
Sources, load and backfeeds
Normal, alternate, transferred load, bypass, tie, PV, storage, UPS and auxiliary paths.
Fault, protection and conductors
Available fault current, marked WCR condition, upstream OCPD, load and terminal limits.
Neutral, bonding and GFP
Solid/switched/overlapping neutral, generator bond, SDS status, sensors and poles.
Power, sensing and controls
Every circuit's function, rating, origin, destination, fail state, routing and protection.
Controlled model-specific work
All-source isolation, absence-of-voltage verification, exact terminal data and inspection.
Commission and hand over
Pre-energization review, approved functional tests, defects, records and final AUTO-ready state.
“OFF” at a controller is not electrical isolation
Before opening or terminating an ATS, apply the employer's written job- and equipment-specific procedure. The worker must be qualified for the exact equipment, sources, voltage and hazards—not merely hold a broad job title.
- Identify every source: normal/utility, alternate/generator, load-side backfeed, bypass or tie, PV, storage, UPS, auxiliary/control power, battery/remote-start energy, and stored electrical or mechanical energy.
- Use energy-isolating means: a controller command, pushbutton, selector, test mode or interlock is not by itself an energy-isolating device.
- Prevent restart and reaccumulation: control the generator start path, stored energy and any condition that can restore voltage or motion.
- Verify the boundary: a qualified person uses suitable test equipment to verify every exposed circuit part is de-energized and checks induced voltage or unrelated backfeed.
- Treat energized testing separately: a commissioning plan does not automatically authorize live work. Use the employer's electrical-safety program and required shock/arc-flash controls only where energized testing is necessary and permitted.
Normal, alternate and transferred load
Do not assume opening one upstream device removes voltage from the other source or from a load-side backfeed path.
Sensing, auxiliary and remote commands
Document each circuit's actual rating. “Control” does not mean low voltage, low energy or de-energized.
Batteries, springs and rotating equipment
Prevent automatic start, motion and reaccumulation under the exact site and equipment procedure.
Lock/tag, verify and control access
Only after the defined boundary is established may the approved model-specific work package proceed.
A family name is not a wiring authority
Record the complete ATS and generator identities before a conductor schedule is prepared. Similar enclosures can conceal different pole arrangements, controller supplies, sensing circuits, terminal capacities, accessories, service-equipment suitability and transition methods.
- ATS identity: manufacturer, full order code, serial, current/voltage/frequency, poles, transition type, controller, firmware if relevant, options and enclosure.
- Generator identity: exact set and controller, output topology, neutral/bond configuration, starting interface, auxiliary supply and protection.
- Project authority: current approved one-line, control schematic, terminal schedule, load study, protection/fault study, equipment submittal and adopted local requirements.
- Application class: state the project classification established by the approved design; do not infer it from a terminal label or marketing description.
- Change control: stop when a nameplate, manual, drawing, option, site condition or field installation disagrees. Resolve the conflict before work continues.
| Identity checkpoint | Evidence to record | Why the distinction matters | Stop condition |
|---|---|---|---|
| Transfer assembly | Full SKU, serial, poles, transition type, controller/options, ratings and product markings. | Different variants may change terminals, neutral treatment, WCR conditions, controls and instructions. | No exact manual or markings disagree. |
| Generator system | Model/controller, output arrangement, neutral/bond data, OCPD, starting interface and auxiliaries. | The ATS and generator form one operating and grounding system. | Start/control or neutral data are uncertain. |
| System classification | Approved design basis, local adoption, AHJ/utility conditions and required performance. | “Standby” and “emergency” classifications can carry different design and testing obligations. | The legal/project class is being assumed. |
| Drawing control | Approved one-line, schematics, I/O list, settings, revisions and field changes. | The final wiring must remain traceable to the approved source of truth. | Two controlled documents contradict each other. |
Start with three named electrical boundaries
Mark the normal/preferred source, alternate/generator source and transferred-load boundary on the approved one-line. Add every disconnect, overcurrent device, neutral path, bypass, tie, onsite source and remote control that can change the real operating state.
Do not use “Emergency” as a generic legal classification. A product terminal may carry that label, but the project's optional-standby, legally required, emergency, fire-pump or health-care classification comes from the adopted rules and approved design.
- Normal/preferred source: voltage, frequency, phases, neutral, phase sequence where applicable, upstream device and available fault current.
- Alternate/generator source: generator topology, protection, neutral arrangement, start/stop logic, auxiliary circuits and operating limits.
- Transferred load: actual downstream boundary, demand, motor or nonlinear behavior, load-shed priorities and required interruption/transition performance.
- Alternative paths: bypass/isolation, second utility, multiple generators, PV, battery storage, UPS, tie breakers and possible load-side backfeed.
Coordinate the ATS as part of the complete power path
An ATS ampere rating answers only one question. The source fault study, marked withstand-and-closing rating condition, upstream protection, load duty, conductor system, terminal limitations and enclosure environment must agree.
| Design layer | What to verify | Evidence required | Do not substitute |
|---|---|---|---|
| Available fault current | Determine the value at the ATS for the normal source, alternate source and any permitted parallel state. | Approved fault study or calculation tied to the installed topology and source data. | A service size, generator kVA or remembered site value. |
| ATS WCR | Confirm the marked short-circuit/short-time withstand-and-closing current rating is at least the available value at system voltage. | Exact ATS markings and listing/certification documentation. | ATS ampere rating, breaker interrupting rating or a generic panel SCCR. |
| Upstream protection | Match the required OCPD type/model or fuse class and its maximum clearing time/settings to the exact marked WCR condition. | Protection schedule, device data and coordination settings. | A different breaker family merely because its current rating matches. |
| Load duty | Confirm demand, continuous duty, motor/inrush, nonlinear load, sequencing, load shedding and transition performance. | Load schedule and operating basis, including future or alternate modes. | Nameplate sum alone or a generic multiplier. |
| Conductors and terminals | Coordinate ampacity, insulation, material, ambient/derating, parallel conductors, routing, lug range, quantity and preparation. | Approved conductor schedule plus exact terminal/lug documentation. | A web size table, a neighboring terminal or a similar frame. |
| Enclosure and installation | Environment, ingress protection, heat, altitude, access, cable entry, bend space, support and clearances. | Project layout, product data and site inspection. | Indoor/outdoor suitability inferred from appearance. |
Fault-clearing boundary: unless the listed ATS assembly includes the overcurrent protective device, the ATS is not the fault-clearing device. WCR remains conditional on the exact marked protection arrangement and, where applicable, its clearing time or short-time setting.
Write one source-specific row for every operating state
A usable review sheet connects the available fault current to the exact ATS marking and upstream protective device. If closed-transition or another permitted parallel state exists, include that state rather than assuming the normal source is always the worst case.
Normal-state duty
Available fault current, voltage, upstream device, clearing condition and ATS marked WCR.
Record the study reference and revision.Generator-state duty
Generator contribution, topology, protection, settings and exact WCR condition.
Do not assume lower kVA means no coordination issue.Parallel-state duty
Combined source contribution, synchronization controls, protection and utility/AHJ conditions.
Closed transition needs its own documented design state.Neutral, bonding, SDS status and GFP cannot be solved separately
If the grounded conductor remains solidly interconnected to the service neutral, the generator is not a separately derived system. Switching the grounded conductor can permit a separately derived topology only when system bonding/grounding and ground-fault protection are designed accordingly.
A three-pole/four-pole label, a service-rated enclosure, an integral breaker or a familiar generator brand does not authorize anyone to add, remove or relocate a bonding connection.
Solid, switched or overlapping?
Record what happens to the grounded conductor in every switch state and whether the exact equipment intentionally overlaps it.
Where is the system connection?
Document the generator and service arrangements from approved design data; do not infer them from enclosure appearance.
What does GFP sense?
Map sensors, return paths, source changes and any neutral switching so fault current is neither bypassed nor misread.
Can the decision be reviewed?
Preserve the one-line, pole selection, bond location, calculations, manufacturer guidance, test method and final as-built state.
| Neutral design question | Record before wiring | Why it changes the project | Unsafe shortcut |
|---|---|---|---|
| Is the grounded conductor switched? | Exact pole arrangement and neutral switching sequence for the installed model. | Changes source interconnection, SDS analysis, bonding and protection behavior. | Assuming “four-pole” settles every decision. |
| Where is the source neutral bonded? | Approved service and generator one-line plus equipment markings. | Parallel neutral-ground paths or a missing system connection can affect safety and GFP. | Moving a bond to stop nuisance operation. |
| How does ground-fault protection see return current? | Sensor locations, neutral path, source states and settings. | A source transition can change the intended measurement loop. | Testing by disabling or bypassing protection. |
| Is the ATS suitable as service equipment? | Exact marking/listing and the approved service arrangement. | An integral breaker or cabinet form does not prove service-equipment suitability. | Inferring it from appearance or a related model. |
Separate power, sensing, start, auxiliary and communications
Do not call the entire control package “low-energy wiring.” A generator interface can include different AC and DC circuits, dry contacts, powered inputs, source sensing, charger or heater supplies, analog/digital I/O and communications. Each needs its own rating, circuit class, insulation, routing, separation, protection and fail-state record.
- Power conductors: normal source, alternate source and transferred-load circuits stay tied to the approved one-line and conductor schedule.
- Source sensing: document origin, voltage/frequency/phase inputs, fusing or protection, neutral reference and accepted controller range.
- Start/control: identify circuit type, normal state, external/internal voltage, origin, destination, permissives and unwanted-start consequence.
- Auxiliary power: controller, charger, heater or accessory feeds may remain energized independently of the main power path.
- Load management: load-shed, inhibit, priority and feedback points need functional ownership and a defined loss-of-signal state.
- Monitoring: alarms, switch position, source status and communications require exact contact ratings, protocol, addressing, shield/earth treatment and point mapping.
Normal source to ATS
Source identity, voltage, phases, neutral, OCPD, fault level, conductor schedule and terminal data.
Keep source, load and pole identity traceable at both ends.Generator source to ATS
Generator topology, protection, neutral, sequence, conductor schedule and exact termination limits.
Do not copy the normal-source circuit without checking source-specific differences.ATS to transferred load
Load boundary, downstream protection, neutral, operating demand, sequencing and required evidence.
The final load record defines what the test actually proves.Source acceptance inputs
Exact sensing source, circuit rating, protection, phase reference and controller limits.
A source-available indication is controller evidence, not a universal power-quality test.ATS and generator interface
Normal state, circuit supply, start/stop behavior, charger or auxiliary interaction and failure response.
Changes can create unintended start or transfer—not only failure to operate.Loads, alarms and networks
Load-shed points, permissives, status contacts, BMS/EPMS mapping, communications and ownership.
Prove every required point against the approved I/O list.
Make only the terminations the approved package defines
The gate opens only after all-source energy control and absence-of-voltage verification are complete. The installer then follows the exact product instructions, conductor schedule, terminal drawing, lug data and inspection plan—without borrowing a number or method from another ATS family.
- Conductor identity: repeat normal, alternate, load, neutral, protective and control tags at the switch and both cable ends.
- Terminal compatibility: verify conductor material, size/range, strand class, quantity, lug or accessory, preparation and insertion against the exact assembly.
- Tightening control: use the specified method/value, suitable calibrated tooling where required, and a documented inspection responsibility.
- Mechanical integrity: preserve bend radius, cable support, clearances, barriers, insulation, door movement, access and enclosure sealing.
- Neutral and protective paths: compare the completed arrangement with the approved grounding/bonding/GFP decision before energization.
- Controls and communications: check terminal identity, circuit rating, normal state, shielding, separation, polarity where relevant and point ownership.
- Change record: resolve substitutions, field conflicts and deviations through the authorized process; update the as-built package.
Separate inspection from necessary energized testing
Commissioning starts before energization with documents, identity, workmanship and continuity of the design record. Energized measurements or functional transfer tests do not become authorized simply because they appear on a checklist. Qualified persons use the exact manufacturer's test and energization order within the employer's electrical-safety program and the approved operating plan.
- Define the proof: state which source states, transition mode, loads, alarms, I/O and abnormal conditions are included—and what remains untested.
- Define roles: operating authority, test leader, generator specialist, load owner, safety authority, witnesses, stop-work authority and restoration owner.
- Define limits: expected source acceptance, phase sequence where applicable, voltage/frequency, delays, interlocks, load shed and recovery states come from the approved package.
- Define stop triggers: unexpected voltage, source position, noise/odor/heat, alarm, load response, controller state, protection operation or a disagreement with the method.
- Define recovery: intended final source, ATS position, AUTO mode, generator state, alarms, remote status, affected loads and temporary equipment removal.
Review the released package
One-line, schematics, I/O list, settings, manuals, protection data, test plan, roles and restoration plan are current.
Match every installed item
ATS, generator, controller, options, poles, labels, OCPDs, accessories and revisions agree with the approved record.
Complete pre-energization inspection
Conductor IDs, terminations, routing, clearances, enclosure, neutral/protective paths and inspection records are accepted.
Apply the exact approved method
Qualified personnel establish the necessary states and compare source acceptance and phase sequence where applicable with approved limits.
Observe the configured sequence
Record start request, source acceptance, transfer/retransfer, delays, interlocks, load response and protection without improvising a failure.
Prove required I/O and loads
Load shed, alarms, position/status, communications and the stated transferred-load boundary are tested only within the approved scope.
Restore automatic-ready state
Confirm intended source, switch position, AUTO mode, generator condition, no unexplained alarm, all affected loads and remote points restored.
Remove authorized temporary jumpers, test leads or overrides; issue settings, results, exceptions, owners, retest needs and as-builts.
Troubleshoot the failed boundary, not a guessed terminal
Record the exact symptom, source states, controller indications, alarms, event log, switch position and affected load. A qualified team can then select the approved diagnostic method without turning a web article into an energized test procedure.
| Observed symptom | Likely boundary to review | Evidence to preserve | Do not do |
|---|---|---|---|
| Generator starts, ATS does not transfer | Alternate-source acceptance, programmed delays/inhibits, transition permissives, controller power and transfer mechanism status. | Exact controller state, alarms/log, generator available indication, settings revision and approved sequence. | Bridge an input, defeat an interlock or force the mechanism. |
| ATS indicates transfer, loads remain dead | Actual switch position, load boundary, downstream OCPD, conductors, protection and load-shed state. | Position evidence, affected-load list, downstream indications, one-line and recent changes. | Assume a display proves the main power path. |
| Ground-fault protection trips during transfer | Neutral switching, bonding, SDS decision, GFP sensors/return path and source-state coordination. | Approved neutral diagram, pole arrangement, source bonds, sensor locations and trip records. | Remove a bond or disable protection to make the symptom disappear. |
| Generator does not receive a start request | Controller state, start/control circuit, auxiliary power, permissives, remote inhibit and generator mode. | Exact I/O list, normal states, alarms, source-sensing state and both controller records. | Apply unknown external voltage or copy another brand's terminal pair. |
| System passes no-load but fails under load | Generator capacity/dynamics, load step, conductor path, OCPDs, protection settings, voltage/frequency limits and load sequencing. | Included load, event timing, source results, protection operations and load-shed states. | Declare the ATS defective from the symptom alone. |
| Remote status disagrees with local indication | Contact normal state, point mapping, auxiliary supply, communications, shared common and stale supervisory data. | Local state, exact point list/register map, timestamps, network status and configuration revision. | Use BMS/EPMS status as the only safe-state evidence. |
Reporting rule: write “not tested” when a function is outside the approved scope. Do not convert a controller lamp, generator start, load-bank result or remote point into broader evidence than it actually provides.
Common mistakes are usually boundary failures
These errors look different in the field, but each begins by substituting an assumption for controlled equipment or system evidence.
Copying terminal labels from another ATS
A product family can change power, sensing, start, auxiliary and communication terminals between variants.
Calling every neutral or ground interchangeable
Neutral switching, source bonding, SDS status and GFP are one designed system—not a color-matching exercise.
Sizing from ampere nameplate alone
Load, fault duty, WCR condition, upstream protection, conductors, terminals and environment all remain separate checks.
Landing controls before the I/O design exists
Control and sensing circuits can carry different AC/DC supplies and create unintended start or transfer states.
Removing jumpers or changing poles to fix a symptom
Factory wiring, neutral arrangement, permissives and controller settings require exact authorization and updated records.
Energizing without staged commissioning
Continuity or a successful generator start does not prove source acceptance, transfer, load output, alarms or final AUTO readiness.
Send the evidence that changes the ATS selection
A productive enquiry does more than ask for an ampere rating. Share the exact project boundary so the supplier, panel builder and responsible designer can identify missing decisions before production or installation.
Close the project so another team can operate it safely
The final record must let an operator identify every source and load state, let maintenance personnel plan safe isolation, and let a future designer understand which ratings and settings were approved.
- As-built electrical record: one-line, control schematic, terminal/conductor schedule, neutral/bond/GFP diagram and field changes.
- Equipment record: nameplates, order codes, options, manuals, certificates, WCR marking/condition, OCPD and accessory data.
- Settings record: source acceptance, delays, transition mode, load shed, alarms, I/O and communications revisions.
- Test record: plan, roles, instruments where relevant, observed events, loads included, results, deviations, corrective actions and retest status.
- Operating record: labels, normal configuration, AUTO-ready checks, authorized manual/test method, stop triggers and escalation contacts.
- Maintenance record: manufacturer intervals, condition baseline, spares, firmware/software controls and responsibility.
Generator ATS wiring decisions
These answers preserve the safety boundary: system choices remain application- and model-specific, and installation is not reduced to a generic terminal sequence.
Can I wire an automatic transfer switch myself?
This work can involve multiple sources, service equipment, high fault current, automatic generator start, hazardous stored energy and energized commissioning. It should be designed and performed by people the employer has determined are qualified for the specific ATS, sources, voltage and hazards, with every license, authorization, permit, utility/AHJ approval and manufacturer procedure required for the project.
What are the three main connections on an ATS?
Conceptually, a generator ATS has a normal/preferred-source power path, an alternate/generator-source power path and a transferred-load output. The complete design may also include neutral, protective, source-sensing, auxiliary-power, generator-start, load-management, alarm and communication circuits. Exact terminals are model-specific.
Does a generator ATS need a switched neutral?
Not universally. Neutral switching follows the approved system topology, source bonding, separately derived system analysis, ground-fault protection and local/project requirements. A pole count or product category alone is not enough to decide it.
Where should the generator neutral and ground connect?
The approved grounding and bonding design determines this. Record whether the grounded conductor remains interconnected or is switched, where the system bonding connection belongs, how protective conductors run and how ground-fault sensors see current. Never move or add a bond from a generic diagram.
How do I size conductors for a generator transfer switch?
Use the adopted design rules and approved calculations for load duty, source characteristics, ampacity, temperature/derating, conductor material, voltage drop where relevant, parallel conductors, OCPD, fault duty, terminal range and installation environment. A generic amperage-to-wire table cannot resolve all of these variables.
Why does my generator run but the ATS not transfer?
The generator may not satisfy the ATS source-acceptance logic, or an inhibit, delay, control-power issue, interlock, protection state, controller fault or mechanism condition may block transfer. Preserve the exact model, indications, alarms/event log, settings and one-line, then use the approved diagnostic procedure; do not force or bypass the switch.
Is an ATS listed to UL 1008 automatically right for my project?
No. Listing or certification is an important product checkpoint, but the exact application still needs verification of system class, voltage/current, transition type, poles/neutral, service-equipment suitability, load, environment, controls, markings and WCR with the required upstream protection condition.
What should be tested after ATS wiring is complete?
After pre-energization document and installation checks, the approved commissioning plan may cover source acceptance, phase sequence where applicable, voltage/frequency, transfer and retransfer, delays, interlocks, load shed, alarms/communications, the defined load boundary and restoration to the intended source and AUTO mode. State what was not tested and preserve all exceptions.
Use current rules and exact product data as design authority
The sources below support the page's safety, WCR, neutral and product-scope boundaries. Apply the editions adopted by the jurisdiction/project and the exact manufacturer documentation for the installed assembly.
UL 1008 boundary: certification does not establish suitability for every system. Verify the exact product markings, application class, transition type, voltage/current, service-equipment suitability, load, neutral, environment and WCR. Equipment above 1000 V and solid-state transfer equipment follow separate standards/frameworks.
