Direct answer

When is a 400 amp generator ATS appropriate?

A 400 A ATS is appropriate when its exact listed configuration matches the calculated transferred load and all application conditions: source voltage, phase, frequency and wire system; generator output and transient capability; poles and neutral treatment; transition mode; available fault current and marked WCR/OCPD condition; service-equipment status; enclosure, terminals, controls and the project’s adopted code path. The ampere number alone cannot close any of those decisions.

Primary selection rule

Start with the one-line diagram, load schedule, generator submittal, short-circuit/coordination study and sequence of operation. Use the model nameplate and controlled documents to confirm the final combination.

Dual-source safety boundary: an ATS can remain energized from utility or generator, and the generator can start automatically. This article is a specification guide—not a wiring, grounding, live-test or manual-operation procedure. Use qualified personnel, the adopted code and local amendments, the approved one-line, exact manuals and site electrical-safety program. Continue with the transfer switch selection guide and the broader ATS buying guide.
Four connected decision gates

A valid 400 A specification must pass all four gates

A strong controller or high fault-current headline cannot repair a mismatch in load, topology or listing.

01 / ELECTRICAL FIT

Sources and transferred circuit

Normal/emergency voltage, phase, frequency, wire count, source topology and exact load distribution.

02 / CAPACITY

Load and generator behavior

Calculated demand, continuous-load treatment, motor/inrush data, largest load step and shedding sequence.

03 / FAULT SAFETY

WCR and protective devices

Available fault current from each source, marked WCR, upstream fuse/breaker type, settings and clearing condition.

04 / OPERATION

Transition, controls and service

Poles, neutral, transition mode, start/retransfer logic, enclosure, maintainability and commissioning records.

What the equipment does

An ATS coordinates a sequence—it does not create generator capacity

A typical automatic sequence monitors the preferred source, confirms a sustained unacceptable condition, issues the engine-start signal, waits until the alternate source is acceptable, transfers according to the selected transition mode, later retransfers after the normal source remains stable, and permits the generator cooldown/stop sequence.

Every sensing threshold, delay, contact logic and acceptable-source window is controller- and project-specific. A published restoration target for a covered emergency power system is not a universal ATS contact-operating time.

  • Confirm the exact start interface and controller compatibility.
  • Define preferred source, source-quality windows and delays.
  • Record load-shed, staged restore, alarms and communications ownership.
  • Verify the mechanical/electrical interlocks and manual controls from the exact manual.

See how an ATS works and the generator transfer switch solution for system-level context.

Generator transfer-switch panel shown as a general equipment example
“Generator Transfer Switch Panel,” shown as a general equipment example. The image does not establish automatic operation, 400 A capacity, conductor requirements, neutral switching, bypass/isolation or an approved topology. Photo: Robert.Harker / Wikimedia Commons, CC BY-SA 3.0. Center-cropped in CSS; adaptation shared under the same license.
Standards route

Name the certification system and adopted code edition

UL and IEC product standards are separate evidence routes. The AHJ determines the enforceable code edition and amendments.

NORTH AMERICAN ROUTE

UL 1008 + adopted NEC

UL 1008 Edition 9 covers transfer-switch equipment up to 1,000 V in nonhazardous locations, including automatic, manual, closed-transition, bypass/isolation and service-equipment configurations.

The 2026 NEC is the latest NFPA edition, but project enforcement follows the edition and amendments adopted by the AHJ. NFPA 110 applies only where invoked by code or project requirements.

IEC ROUTE

IEC 60947-6-1:2026

The current IEC product standard covers manual, remote and automatic transfer switching equipment, including bypass/isolation and closed-transition TSE, within its voltage scope.

An IEC ATSE declaration is not a substitute for UL 1008 listing, and a UL Type/category label is not an IEC utilization-category crosswalk. Put the required route in the RFQ.

Twelve fields to freeze

“400 A ATS” is only the first line of the schedule

Each card adds a condition that can change the order code, tested rating, physical fit or operating result.

01 / RATED CURRENT

400 A frame/nameplate

Match the calculated transferred circuit and exact assembly conditions.

Does not equal generator current or prove every assembly is 100%-rated.
02 / VOLTAGE

Both sources and the load

Normal and emergency voltages must match the ATS power path and sensing configuration.

A field-selectable controller does not make every power section universal.
03 / PHASE + Hz

Source configuration

Confirm single/three phase, wire system, frequency, phase rotation and source compatibility.

Never repurpose a different phase or voltage product by nameplate similarity.
04 / POLES

Neutral treatment

Two-, three- or four-pole selection follows the complete grounding and protection scheme.

Three phase does not automatically require four poles.
05 / LOAD

Demand and transient profile

Record continuous components, motor starts, nonlinear loads, largest step and sequence.

Connected load and service size are not substitutes for the project load study.
06 / WCR

Withstand and closing rating

Apply the marked rating at the actual voltage and available fault current.

WCR is not the interrupting rating of a plain ATS.
07 / OCPD

Tested protective condition

Identify fuse/breaker type, manufacturer family, rating, settings and clearing-time limits.

Specific-breaker, any-breaker, fuse and short-time ratings are different conditions.
08 / TRANSITION

Open, delayed or closed

Choose from load interruption tolerance, residual voltage, synchronization and utility rules.

Closed transition does not eliminate generator start time during an outage.
09 / SERVICE USE

Listed application position

State service-equipment or downstream feeder use, disconnects, metering and bonding.

Service-entrance rated does not mean outdoor or waterproof.
10 / CONTROLS

Sequence and interfaces

Start contacts, sensing, delays, load shed, alarms, protocol, cybersecurity and ownership.

Two-wire start and contact logic still need exact model verification.
11 / CONSTRUCTION

Enclosure and terminals

Location, environment, lug range/count, conductor material, cable entry, bend space and access.

Never publish a universal cable size or torque for all 400 A models.
12 / EVIDENCE

Controlled product record

Exact SKU, drawings, listing/certificate, manual, WCR table, settings and test records.

Series-name similarity does not authorize a substitution.

Use the UL 1008 ATS testing guide to keep certification evidence separate from marketing claims.

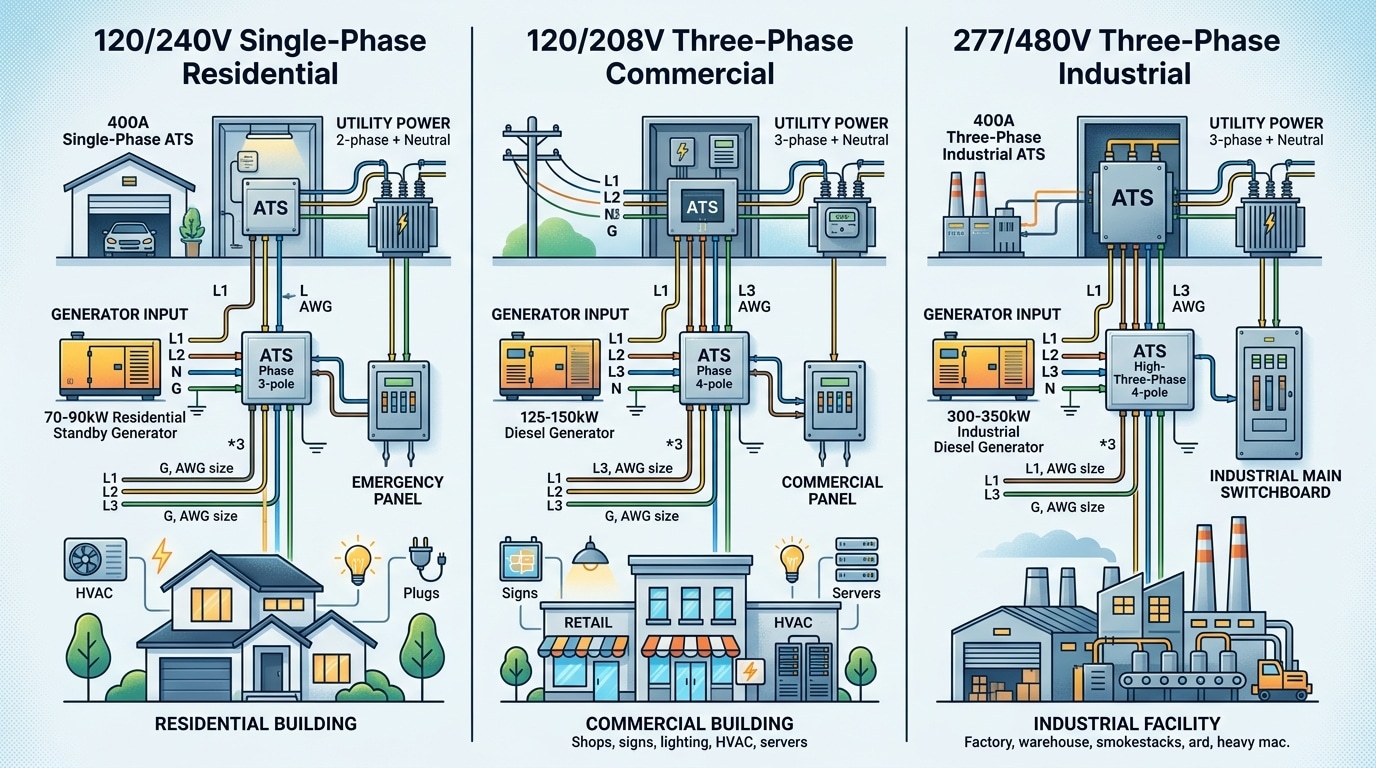

Current is not power

Use kVA math as a boundary check—not a generator recommendation

Apparent power changes with voltage and phase. Real generator selection also needs power factor, load steps, motor starting, harmonics, derating and the required operating sequence.

240 V / SINGLE PHASE96 kVA240 × 400 ÷ 1000

Arithmetic at 400 A only. It does not authorize a 96 kW load or select a generator.

208 V / THREE PHASE≈144 kVA√3 × 208 × 400 ÷ 1000

Balanced three-phase arithmetic; real loads and generator transient behavior still control.

480 V / THREE PHASE≈333 kVA√3 × 480 × 400 ÷ 1000

Not a recommendation for a 300 or 350 kW generator and not permission to load every assembly to 400 A.

Backup generators and associated electrical hardware at a data center
Backup generators and associated electrical hardware at a data center in Mesa, Arizona. The source supplies no generator ratings or transfer-switch configuration; facility scale does not establish a 400 A requirement. Photo: Rsparks3 / Wikimedia Commons, CC0 1.0. Center-cropped in CSS.
Load study and generator acceptance

Model what transfers—and in what order

Separate life-safety or code-required loads, business-critical loads, comfort loads and optional loads. Record steady-state demand, starting method, locked-rotor or inrush behavior, nonlinear load characteristics and the largest proposed load step.

  • Confirm what must be connected within each required restoration window.
  • Test generator voltage and frequency response against planned load steps.
  • Define shed priorities and staged restore logic before controller I/O is frozen.
  • Coordinate UPS, VFD, elevator, pump, compressor and process-load behavior.

See how to calculate ATS amperage and frame the complete generator and standby system.

Transition modes

Choose the source-transfer sequence around the load

The exact delay, synchronization window and interruption depend on the product and project. Do not copy universal millisecond values.

OPEN

Break before make

The load disconnects from one source before connection to the other and experiences an interruption.

Ask whether the load can tolerate the interruption and how in-phase monitoring is applied.
DELAY

Programmed open interval

The ATS holds the load disconnected for a defined interval before connecting the alternate source.

Useful where motor residual voltage or transformer/UPS behavior requires decay time.
CLOSED

Controlled make before break

When both sources are acceptable and synchronized, the switch briefly parallels them during transfer.

Requires suitable equipment, interlocks, protection and utility/AHJ coordination; it does not bypass generator start.
Neutral configurations

Pole count follows grounding and protection—not habit

Show every neutral and bonding point on the one-line. Overlapping neutral is not the same thing as closed transition of phase conductors.

SOLID

Neutral remains connected

A three-pole three-phase ATS commonly transfers the phase conductors while the neutral remains solid.

Confirm separately derived system status and ground-fault sensing.
SWITCH

Neutral is a transferred pole

A four-pole three-phase ATS connects the load neutral to only the selected source neutral.

Coordinate generator bonding, grounding electrodes and protection.
OVERLAP

Neutral continuity by design

A listed overlapping-neutral mechanism can maintain neutral continuity while phase conductors use load-break transfer.

Availability, timing and application are model-specific.

Use the 3-pole versus 4-pole ATS guide with the approved transfer switch wiring architecture; neither is a substitute for the final grounding study.

Fault-current application

WCR, AIC and available fault current are different fields

A 400 A frame does not establish a universal 10, 22, 35, 65, 100 or 200 kA rating.

ATS / WCR

Withstand and close onto a fault

The ATS must survive the defined fault condition until the specified protective device clears it. Apply the marked voltage, device type, rating, settings and time conditions.

BREAKER OR FUSE / AIC

Interrupt the fault current

Interrupting rating belongs to the protective device. A plain transfer switch does not acquire an interrupting rating because it is installed beside a breaker.

SYSTEM / AVAILABLE CURRENT

Calculate at the ATS location

Evaluate the normal and emergency source conditions, location, conductor/source impedance and study assumptions. Do not use a generic service value.

Protection and service architecture

Read the exact WCR table and service-equipment marking

Some ratings are conditional on a particular breaker family, fuse class/rating, instantaneous setting or short-time clearing relationship. Intentional breaker delay for selective coordination must remain within the ATS marked condition. Freeze the exact protective device in the submittal and re-review substitutions.

An ATS used as service equipment must be specifically listed and marked for that role and coordinated with the service disconnect, overcurrent protection, neutral bonding, grounding-electrode system, metering, utility rules and AHJ requirements. “400 A” and an outdoor enclosure code do not prove service-equipment suitability.

Connect the project short-circuit study with the circuit-breaker short-circuit rating guide.

Electrical switchgear in a large-building distribution room
Electrical switchgear in the main distribution room of a large building. This is generic switchgear, not a documented ATS, service-rated assembly or 400 A installation; enclosure size cannot establish electrical ratings. Photo: P199 / Wikimedia Commons, worldwide public-domain dedication. Center-cropped in CSS.
SER

Service-equipment configuration

Potential fit when the listed ATS assembly performs the intended service disconnect/protection functions.

Verify listing, neutral/bonding, metering, utility rules, WCR and exact one-line position.
FEEDER

Non-service-entrance ATS

Applied downstream of separate service equipment and its overcurrent/disconnect arrangement.

Coordinate feeder protection, access, service classification and downstream distribution.
BYPASS

Bypass-isolation architecture

Can support maintenance while an alternate power path remains available in a critical facility.

Not mandatory because the frame is 400 A and does not make every compartment safe to touch.
Eight-stage control narrative

Write the full automatic sequence before procurement

Exact thresholds and delays belong in the approved settings schedule. NFPA 110 Type 10 is a complete EPSS restoration classification where applicable—not a universal ATS mechanism time.

01

Monitor normal source

Voltage, frequency, phase loss/rotation and preferred-source conditions as applicable.

02

Confirm failure

Use the project-defined delay to distinguish a sustained unacceptable source from a transient.

03

Issue generator start

Define contact type, failsafe behavior, controller ownership and start-circuit supervision.

04

Qualify emergency source

Wait for acceptable generator voltage/frequency and any applicable stabilization interval.

05

Transfer the load

Execute open, delayed or closed transition with the required interlocks.

06

Sequence and shed

Connect priority loads, stage subsequent loads and shed according to generator capability.

07

Retransfer after recovery

Require the normal source to remain acceptable for the approved retransfer interval.

08

Cooldown and stop

Coordinate unloaded run, stop logic, alarms, event records and exercise/manual modes.

Trapped-key interlock on a switchgear cabinet door
A trapped-key interlock on one switchgear-cabinet door; the documented arrangement keeps an upstream device open while that cabinet is open. It does not prove that another ATS provides equivalent isolation or uses the same sequence. Photo: Wtshymanski / Wikimedia Commons, CC BY-SA 4.0. Center-cropped in CSS; adaptation shared under the same license.
Maintainability and environment

Bypass, isolation and enclosure choices need their own evidence

Bypass-isolation equipment can improve maintainability for facilities that cannot schedule a complete transfer-equipment outage, but it adds interlocks, space, operating steps, training and fault-duty questions. Isolation labels and key schemes are exact-product functions—not generic promises.

  • Define the maintenance operating state and every energized boundary.
  • Confirm bypass duty, isolation sequence, interlocks and approved one-line position.
  • Specify indoor/outdoor exposure, contaminants, temperature, flood/seismic needs and access.
  • Verify lugs, conductor count/material, cable entry and bend space from drawings.

Use the bypass-isolation ATS requirements and outdoor ATS enclosure guide. NEMA 3R is not waterproof, washdown-safe or floodproof.

Eight-step selection workflow

Move from one-line diagram to controlled order code

This is an engineering and procurement sequence, not a field-installation method.

01

Name the code path

State UL/IEC route, adopted NEC and amendments, system class, AHJ and utility requirements.

02

Freeze both sources

Document voltage, phase, wire count, frequency, topology and source locations.

03

Study load and generator

Calculate transferred demand and model starting, inrush, largest step, shed and restore.

04

Resolve poles and neutral

Show grounding, bonding, separately derived status and ground-fault sensing.

05

Close WCR application

Match available fault current to the exact ATS/OCPD rating condition.

06

Select transition and service

Choose operating sequence, service-equipment position and any bypass-isolation need.

07

Define controls and construction

Start logic, delays, I/O, monitoring, enclosure, lugs, cable entry and maintenance access.

08

Release controlled evidence

Exact SKU, revisions, certificates, drawings, settings, tests, training and substitution rules.

For project support, review the ATS manufacturer and OEM capability and electrical project applications.

Six selection failures

Replace each shortcut with a controlled check

Stop the submittal when the equipment schedule, one-line, study and controls narrative disagree.

MISTAKE 01

Select by amperage alone

Add voltage, phase, load, generator, poles, WCR, service position, controls and environment.

MISTAKE 02

Size from a generator breaker label

Use the transferred-load study and generator transient response, not one protective-device number.

MISTAKE 03

Choose 3 or 4 poles by habit

Resolve grounding, bonding, separately derived status and ground-fault sensing first.

MISTAKE 04

Quote a WCR without its OCPD

Keep the tested voltage, breaker/fuse family, rating, settings and clearing condition attached.

MISTAKE 05

Assume closed is always better

Momentary paralleling adds synchronization, interlock, protection and utility/AHJ requirements.

MISTAKE 06

Leave controls to the field

Issue an approved sequence, I/O list, settings schedule and commissioning script before release.

Use the diagnostic boundary in why an ATS fails to transfer and plan periodic evidence with the ATS inspection and maintenance guide.

Eight RFQ data blocks

Make every 400 A quotation technically comparable

Attach the one-line, load schedule, generator submittal, short-circuit/coordination study and sequence of operation.

Electrical system

Both sources: voltage, phase, frequency, wire count, topology, grounding and locations.

Rating and poles

400 A class, calculated transferred load, continuous-load basis, poles and neutral configuration.

Fault duty

Available current from each source, X/R if required, WCR and exact OCPD condition.

Transfer sequence

Open/delayed/closed mode, preferred source, interruption limit, delays and retransfer logic.

Service architecture

Service-equipment or feeder position, disconnects, metering, bypass/isolation and utility input.

Generator interface

Generator/controller model, start circuit, transient data, load shed/restore and monitoring.

Construction

Environment, enclosure, terminals, conductors, cable direction, working space and maintainability.

Closeout evidence

Exact SKU, controlled documents, factory/field tests, settings, training, as-builts and spares.

Use the SENTOP product catalogue only after the application fields are fixed. The generator ATS installation overview supports qualified planning but is not a project wiring instruction.

Commission the complete system

Prove the approved sequence—not just switch motion

Plan commissioning before installation. Qualified personnel should follow the approved procedure and exact manufacturer instructions, with utility and generator sources, autostart, remote commands and stored/control energy addressed by the site safety program.

  • Reconcile submittals, one-line, labels, settings, torque records and protection configuration.
  • Verify source characteristics and phase relationship by the approved qualified-person method.
  • Demonstrate start, source qualification, transfer, load acceptance, alarms, shed/restore, retransfer and cooldown.
  • Record settings, event logs, deficiencies, as-builts, training and maintenance ownership.

NFPA 110 Type, Class, Level and testing provisions apply only where that standard is invoked. Do not universalize a monthly test or 10-second result to every optional standby ATS.

Personnel reviewing lockout and tagout procedures during a safety stand-down
“Lockout / Tagout.” NAVFAC personnel review procedures during a 2014 safety stand-down. Reviewing a procedure does not prove equipment is de-energized; ATS work must address both sources, autostart, remote commands, backfeed and verified absence of voltage. Photo: NAVFAC / Wikimedia Commons, CC BY 2.0; Commons also identifies it as a U.S. Navy public-domain work. Center-cropped in CSS.
Related resources

Continue from selection to release

Keep the exact standard, model and project conditions attached to every next step.

Frequently asked questions

400 amp generator ATS FAQ

Nine concise answers for current rating, generator capacity, topology, WCR and submittal evidence.

Is a 400A ATS the same as a 400A generator?

No. The ATS current rating and generator capacity are separate. Select the generator for the actual kW and kVA, power factor, transient loads, motor starting, environmental derating and operating sequence; select the ATS for the transferred circuit and its complete application conditions.

How large a generator does a 400A ATS need?

There is no universal answer. Voltage, phase, calculated transferred load, power factor, motor starting, nonlinear loads, load shedding, environmental conditions and generator performance determine the required generator. Use a load and transient study.

How much kVA does 400A represent?

It depends on voltage and phase. Arithmetic examples are 96 kVA at 240 V single phase, about 144 kVA at 208 V three phase and about 333 kVA at 480 V three phase. These figures are not generator recommendations and do not account for real power, transients, derating or assembly conditions.

Do I need a 3-pole or 4-pole 400A transfer switch?

That depends on the complete neutral, grounding, bonding, separately derived system and ground-fault protection design. A three-phase system does not automatically require four poles. Have the electrical designer and equipment manufacturers confirm the arrangement.

What is WCR on an ATS?

WCR is the withstand and closing rating under defined test conditions. Verify the marked rating against available fault current at the ATS and apply the exact voltage, upstream fuse or breaker type, rating, settings and clearing-time conditions. WCR is not the interrupting rating of a plain ATS.

Can a 400A ATS be used as service equipment?

Only when the exact listed and marked model and project arrangement support service-equipment use. Coordinate the service disconnect, overcurrent protection, neutral bonding, grounding-electrode system, metering, utility rules, WCR and adopted local requirements.

Should I choose closed transition?

Choose it only when the load need, source synchronization, protection design, utility and AHJ requirements, and exact equipment ratings support momentary paralleling. Closed transition does not eliminate generator start time after an outage; open or delayed transition may be the better system choice.

Can I add load shedding later?

Possibly, but it depends on ATS controller I/O, generator controls, field wiring, load-control equipment, communications and the approved sequence. Define priority loads, shed logic and staged restoration before procurement whenever possible.

What documents should accompany the final ATS submittal?

Include exact product data and listing evidence, connection and control drawings, WCR and protective-device tables, controller sequence and settings schedule, enclosure and terminal data, generator interface details, factory and field test requirements, training, as-builts and substitution controls.

Specify the complete transfer system—not only 400 A

Share the one-line, load schedule, generator submittal, source/grounding details, available fault current, required code route, transition sequence and controls narrative for a model-specific review.

滚动至顶部
